Arden Cordova
Drought
Golden State Water has activated its Staged Mandatory Water Conservation & Rationing (Schedule 14.1) filings that outline restrictions, water allocations, enforcement measures and surcharges designed to achieve reductions due to water supply shortages or to achieve identified water usage goals established by an authorized government agency or official.
The Arden Cordova community is in Stage 2 as of June 26, 2022. Under this stage, all outdoor irrigation is limited to two days per week. Outdoor irrigation is allowed only after 7PM and before 8AM, according to the schedule below.
Golden State Water customers who do not meet the Stage 2 mandatory 20% reduction in water use may be charged a drought surcharge of up to $2.50 per Ccf (or 748 gallons) for all usage in excess of the customer’s usage allocation. While Golden State Water is not currently implementing surcharges, we are closely monitoring water supply conditions and customer water usage and may implement surcharges if it becomes necessary to spur action and additional conservation.
Addresses Ending In | Watering Days |
---|---|
Even Numbers (0, 2, 4, 6, 8) |
Sunday, Wednesday |
Odd Numbers (1, 3, 5, 7, 9) |
Tuesday, Saturday |
Rates
As a regulated utility, Golden State Water’s rates are determined by the California Public Utilities Commission (CPUC) through a General Rate Case (GRC) to ensure customers receive a fair rate for reliable, quality water service.
- On July 15, 2020, Golden State Water filed a GRC application for the years 2022, 2023 and 2024. Learn more: 2022-24 GRC Fact Sheet
- Effective Sept. 27, 2019, an average metered customer in the Arden Cordova Customer Service Area would see a monthly bill increase of $0.069 per 748 gallons (1 Ccf), or approximately 2.4 percent, during the 24-month amortization period, and an average flat rate customer in the Arden Cordova Customer Service Area would see a monthly bill increase of $2.13, or approximately 2.4 percent, during the 24-month amortization period.
- Effective June 8, 2019, an average residential customer in the Arden Cordova Customer Service Area with a 5/8 x 3/4” meter using 13 Ccf per month would see a monthly bill increase of $4.72 from $30.47 to $35.19 compared to 2018 (excluding any applicable surcharges).
- On May 30, 2019, Golden State Water’s GRC was approved by the State of California to set water rates for 2019, 2020 and 2021 and authorize infrastructure investments for the local system. New rates were implemented effective June 8, 2019. Learn more here. (English | Spanish)
- On July 1, 2018, local water rates decreased by 2.88% (metered customers) and 2.86% (flat-rate customers) to pass cost savings from the new lower federal corporate income tax requirement through to customers. Click here to learn more.
Learn More
- 2022-24 GRC Fact Sheet
- Rates - General Metered Service
- Rates - Flat Rate Service
- Rates-Flat Rate Services
- Low Income Assistance
- Proposed Rate Information
- System Map - Arden
- System Map - Cordova
- System Map - Robbins
- Schedule 14.1
Capital Projects
More than $6.2 million in infrastructure improvements are planned for 2022 in the Arden Cordova service area.
The 2022 investments include water supply enhancements, distribution and ongoing improvements designed to replace old meters, mains and safety equipment. Click here to learn more and access a list of projects planned for 2022.
Current & Upcoming Projects
Recently Completed Projects
Trussel Plant
East end of Trussel Way in Arden
Investment:
$2.6 million
Project Timeline:
Feb. 4, 2019 – Jan. 22, 2020
Working Hours:
Monday – Friday (No weekends or holidays)
8 a.m. – 5 p.m.
Construction crews will work to:
- Construct groundwater well
- Construct 400,000-gallon water storage tank
- Install 3 booster pumps
- Install 1 generator
- Construct disinfection building
- Execute necessary street improvements
This project will improve the distribution system and ensure Golden State Water can continue providing reliable water service to local customers.
Click here to view the construction notice.
Coloma Reservoir
Cordova system of the Arden-Cordova customer service area
Investment:
$1.58 million
Project Timeline:
Oct. 16, 2018 – January 2020
Construction crews worked to:
- Recoat interior of Coloma Reservoir No. 3 and the clarifier
- Conduct structural and safety improvements to the reservoir and clarifier
- This project will ensure Golden State Water can continue providing reliable water service to local customers.
Rancho Cordova
Folsom Blvd. from Zinfandel Dr. to Don Juan Dr. and McGregor
Dr. to Hwy. 50
Investment:
$900,000
Project Timeline:
Nov. 6, 2018 – June 11, 2019
Working Hours:
Monday – Friday (No weekends or holidays)
8:30 a.m. – 3:30 p.m.
Construction crews worked to:
- Install 500 LF of 16-inch pipeline
- Install 1,270 LF of 12-inch pipeline
- Install 135 LF of 8-inch pipeline
- Install 3 fire hydrants
This project will improve the distribution system and ensure
Golden State Water can continue providing reliable water service
to local customers.
Rancho Cordova

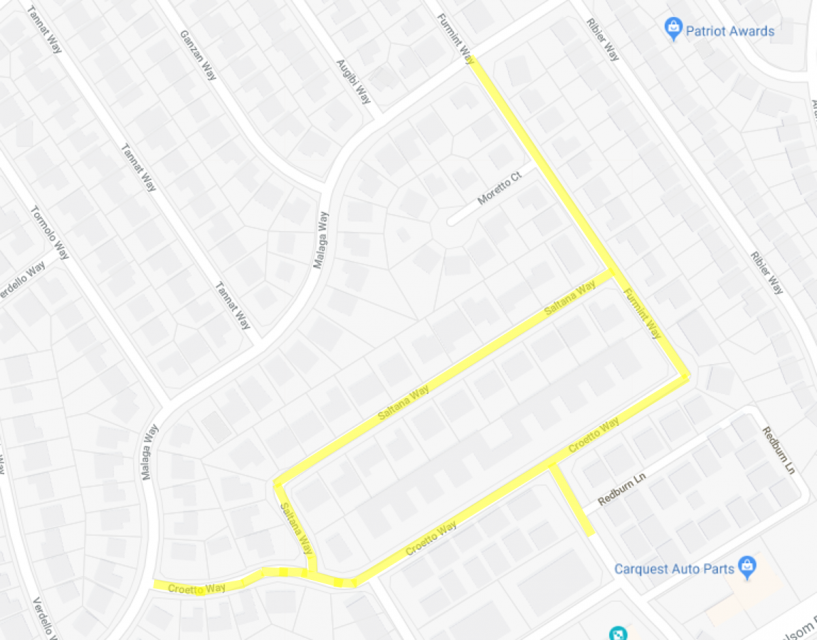

Saltana Way, Croetto Way, Furmint Way and Woodberry Way
Investment:
$1.3 million
Project Timeline:
October 15, 2018 – December 2018
Working Hours:
Monday – Friday (No weekends or holidays)
8 a.m. – 5 p.m.
Construction crews worked to:
- Install 2,800 LF of pipeline
- Install 7 fire hydrants
- Install 41 services
This project will improve the distribution system and ensure Golden State Water can continue providing reliable water service to local customers.
Click here to view the construction notice.
Rancho Cordova
Pedro Way, Malbec Ct., and Zinfandel Dr. from Alicante Way to
Barbera Way
Investment:
$965,000
Project Timeline:
October 25, 2017 – March 2018
Working Hours:
Monday – Friday
7 a.m. – 5 p.m.
Construction crews worked to:
- Install approximately 5,800 ft. of water pipe
- Connect new water pipe to existing pipes
This installation replaced a 50-year old steel pipe, improved the hydraulics of the water system and provided more reliable service to our customers.
Click here to view the construction notice.
Rancho Cordova
North of Folsom Blvd. and West of Sunrise Ave.
Project Timeline:
June 5, 2017 – September 8, 2017
Working Hours:
Monday – Friday
7 a.m. – 5 p.m.
Construction crews worked to:
- Install approximately 141 water meters in both front and back yards
Click here to view the construction notice.
